New Concrete Driveway Installation · Warren

New Concrete Driveway Installation in Warren, MI

What a 4 inch reinforced slab poured to current Michigan spec actually looks like, start to finish.

1 to 2 days installs · typical timeline
Free Quote

Free New Concrete Driveway Installation quote.

We reply within 1 business hour. No spam, ever.

Finished broom-finish concrete driveway leading to a brick home.

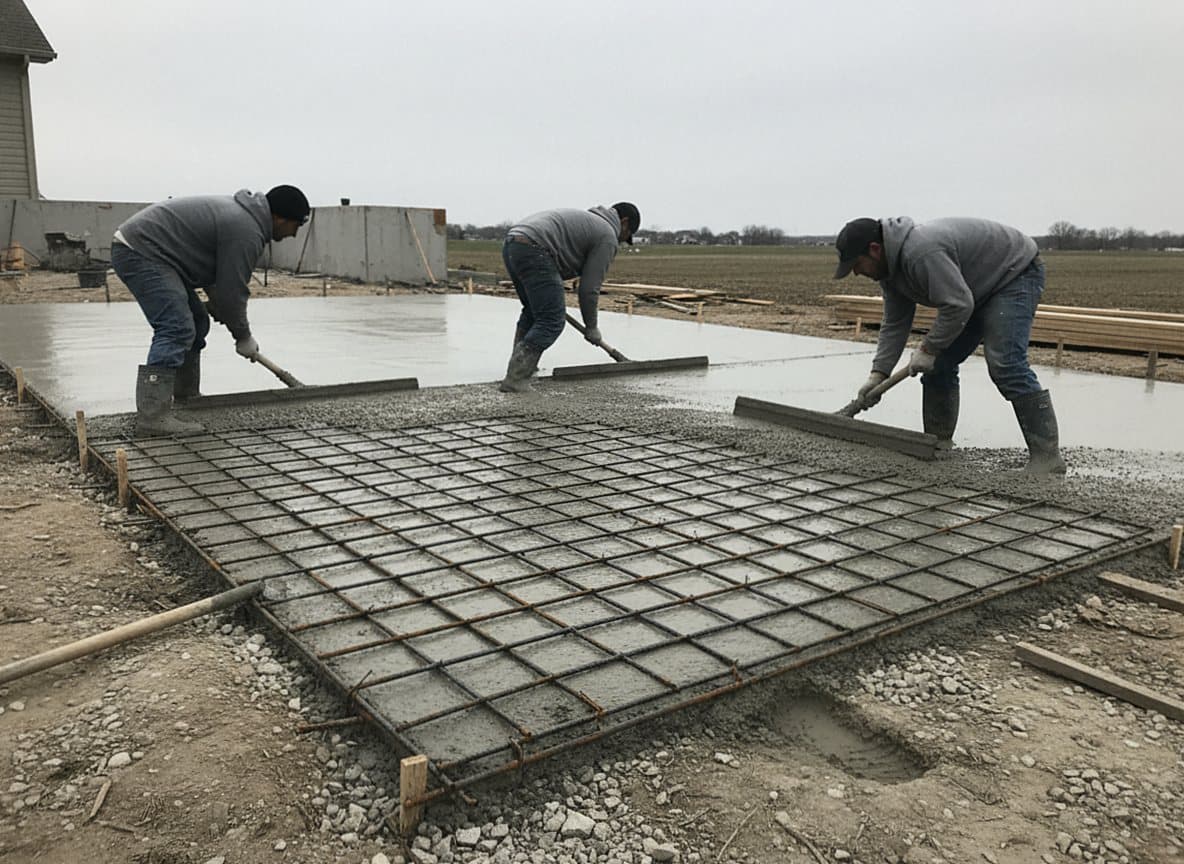

Crew floating fresh concrete over a steel rebar grid.

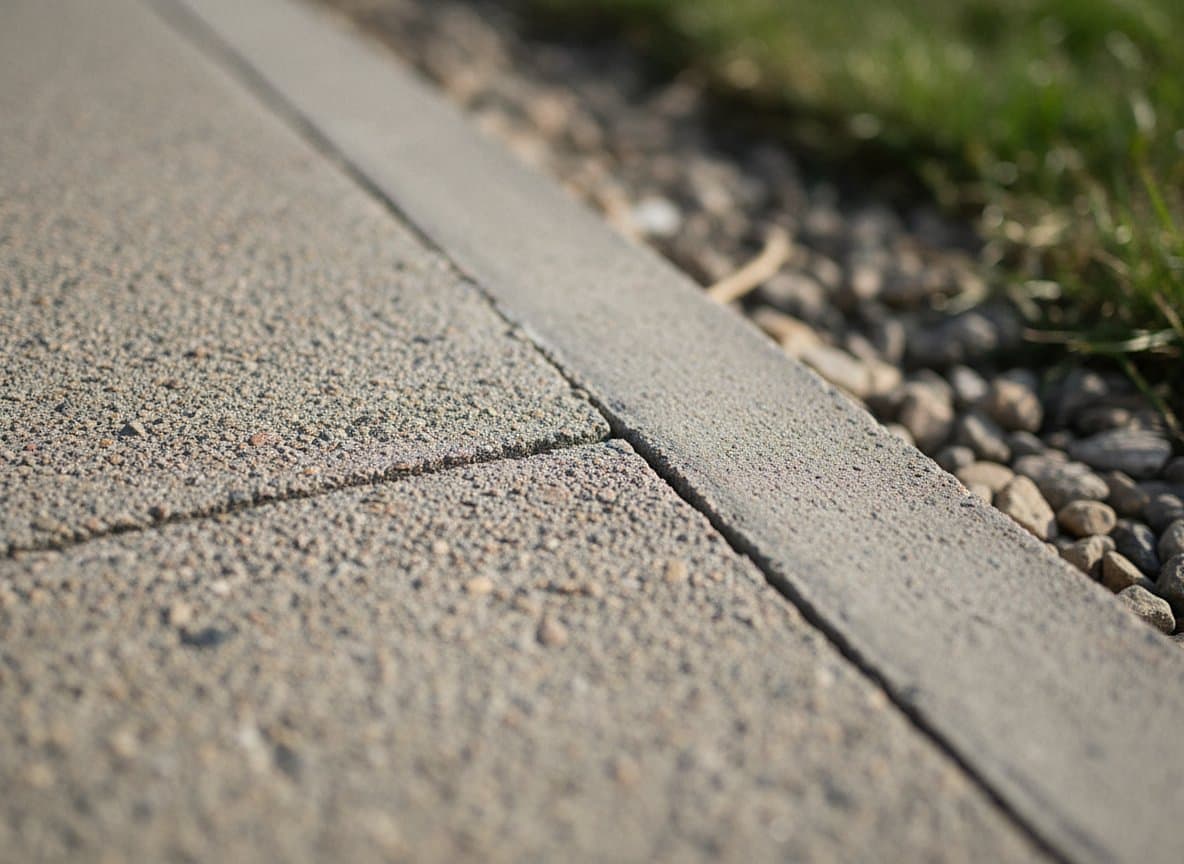

Control joint along a concrete slab edge by gravel.
What we install

What goes into a new driveway that holds up in Michigan

Most Warren homeowners putting in a new driveway start from one of three spots: bare dirt where a driveway never sat, a gravel pad that needs upgrading, or a finished lot on a new build that still needs the apron and the run from the garage to the street. The site changes how much base prep we do. The slab spec does not. A residential driveway on Macomb County clay needs a 4 inch reinforced slab, a 4,000 psi mix that carries entrained air, and control joints we cut in with a saw at the right spacing. Pour it any lighter than that and it fails inside the first decade.

Our pours run in a clear sequence. First we grade the base to fall away from the house, usually a quarter inch per foot. We lay 4 to 6 inches of crushed limestone and compact it in lifts so it locks together, then set the forms to the edges along the apron grade. We tie continuous steel rebar on chairs, usually 3/8 inch bar on an 18 inch grid, and the chairs lift the steel into the middle of the slab where it does real work. We pour a 4,000 psi mix that carries entrained air, because a Michigan freeze and thaw chips the surface off any leaner mix. Once we float the surface smooth, we drag a broom finish over the top for winter traction. We saw the control joints in at one and a quarter times the slab thickness apart, so the slab cracks along the lines we chose instead of wherever it wants.

  • A 4,000 psi mix with entrained air that meets current Michigan spec for exterior concrete.
  • Continuous 3/8 inch steel rebar on an 18 inch grid, tied above the base.
  • A broom finish for grip, because a glassy steel troweled slab turns slick the first icy morning.
  • Control joints cut in with a saw at the right spacing, not creased in by hand.
  • Compacted limestone base in lifts, the layer most cheap bids skip first.
Most driveways do not fail because the concrete was bad. They fail because the base was light or the slab was thin.

Warren and the cities around it (Sterling Heights, Roseville, Fraser, Clinton Township, Shelby Township, Utica, Macomb Township) all sit on the same heavy clay that heaves when a slab goes in too thin. We write the slab thickness, the rebar spec, the psi number, and the joint spacing straight into the quote, not as a verbal promise. A bid that just says concrete driveway with a price next to it has left out the layers that decide whether it lasts.

If you are putting a brand new driveway on a Warren lot, the form or the phone number above reaches us, and we handle the whole job from base prep through the final broom finish. Free walk through, and a fixed written quote inside one business day.

Materials

The four layers of a driveway pour, and why each one is there

The first layer is the base, and it is the one cheap bids cut first. The native soil under most Macomb County yards is clay, and clay swells when it gets wet and shrinks when it dries. A slab poured straight on raw clay flexes with the soil, cracks within a year, and tilts within five. We give it a stable bed instead: 4 to 6 inches of compacted limestone that drains water away from the underside rather than trapping it against the concrete. We compact that base in lifts, a few inches at a time, rolled or tamped with a plate compactor before the next lift goes on. A base dumped in one shot and rolled once on top packs only the top inch, which is why driveways on cheap base prep sink at the edges within three winters.

The second layer is the steel. We run continuous 3/8 inch rebar on an 18 inch grid across the slab, and it does two jobs. It holds the slab together when shrinkage cracks form, and they form whether or not a joint is cut. The steel keeps the two sides of a crack from separating and tilting against each other, and it bridges the slab over any soft spot that slips past the compaction step. The third layer is the concrete itself, a 4,000 psi mix that carries entrained air. The plant whips tiny bubbles into the mix, so when water freezes inside the slab it has room to expand without spalling the surface off. The fourth layer is the finish. The broom drag gives traction, and the saw cut joints handle crack control. We cure the slab at least 7 days under wet burlap or a curing compound before any vehicle weight goes on it.

  • 4 to 6 inch crushed limestone base compacted in lifts, not dumped in one go.
  • Continuous 3/8 inch steel rebar on an 18 inch grid, tied above the base on chairs.
  • A 4,000 psi mix with entrained air that resists Michigan freeze and thaw spalling.
  • Broom finish for winter traction, joints cut in with a saw at 1.25 times the slab thickness.

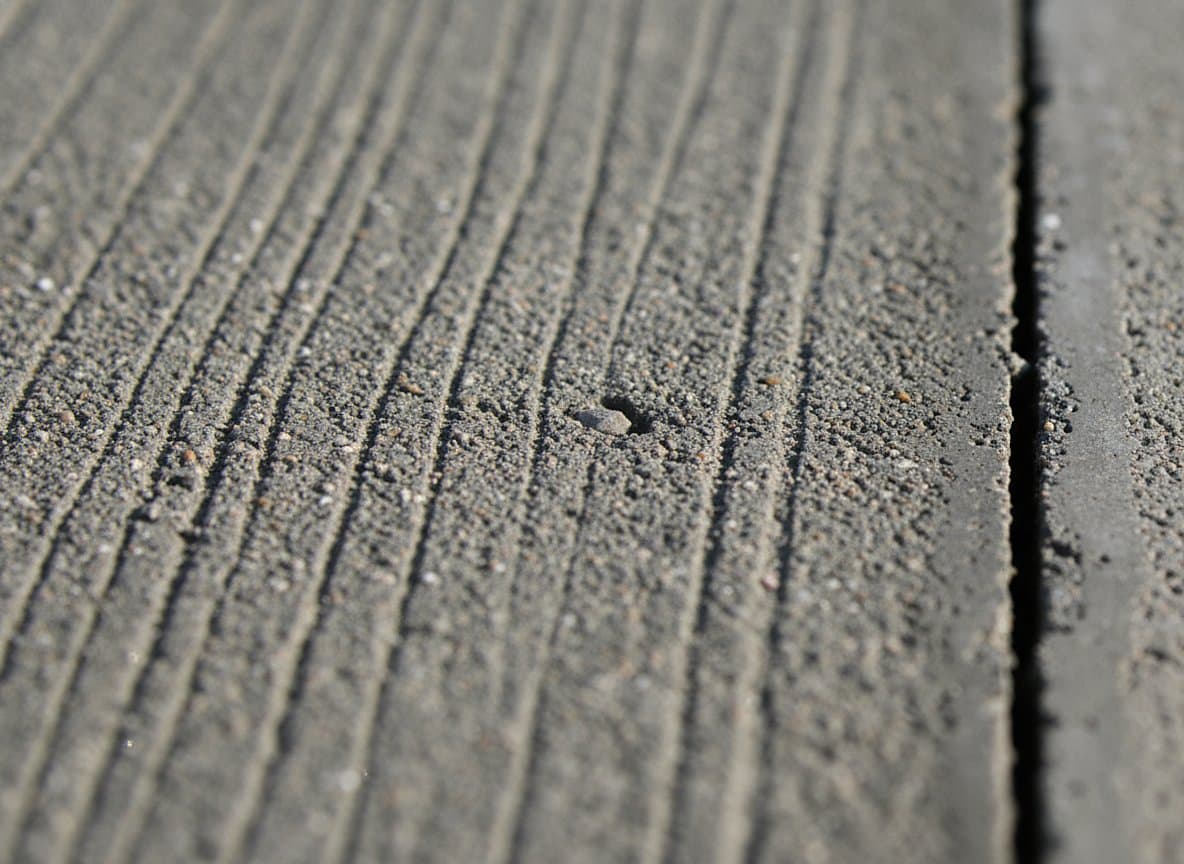

Macro of broom-finished concrete texture beside a joint.
What about the alternatives?

What homeowners weigh against a poured concrete driveway

When you are adding a driveway, you weigh a few obvious alternatives before you settle. Here is how each one holds up on Macomb County clay.

Asphalt driveway

Costs less up front and goes down fast. In exchange you reseal every 2 to 4 years, watch it soften in July heat, and plan on a tear out around year 15 to 20.

Acceptable

Gravel driveway

The lowest bill of the four and almost no upkeep, with a country look. The trade: stones ride into the garage on your tires, wheel ruts form where you park, and a snow shovel fights loose rock all winter.

Acceptable

Pavers or interlocking brick

Top of the price range. The look is high end and any single paver can be swapped out later. On Warren's heavy clay they heave out of level unless the crew builds a deep base first.

Acceptable

Cheap thin concrete pour (3 inch, no rebar, 3,000 psi)

Looks identical to a real driveway on day one. Cracks heavily by year 3, spalls by year 5, fails inside a decade.

Skip

Standard 4 inch reinforced concrete driveway

The job described above. A 4,000 psi mix with entrained air on a compacted limestone base. Built this way, a slab holds up for decades with light care.

Recommended
How it goes

From quote to walk-on, fast.

01

Free walk-through

02

Base and forms

03

Rebar and pour

04

Finish and cure

Before you book

Things to confirm before signing a new driveway contract

We answer all of these straight during the walk through at your property. If a bidder pushes back on any of them, take that as your signal to keep looking.

How deep is the base and what material is it?
Under the slab goes 4 to 6 inches of crushed limestone, the 21AA or 22A grade Michigan suppliers carry, compacted in two or three passes with a plate compactor or roller. Clay alone will not carry a driveway, pea gravel will not either, and one thin lift rolled once is not compaction. Make sure the base spec is written into the quote instead of promised out loud.
What is the slab thickness and the rebar spec?
Four inches of concrete is the floor for a residential drive. Through it runs continuous 3/8 inch rebar tied on an 18 inch grid, the standard here in Michigan. Some bids swap in wire mesh to shave cost. Mesh only works when it is propped on chairs into the middle of the pour, and on real job sites that step gets skipped, so it sits useless at the bottom of the slab.
Why does the mix need to be 4,000 psi if 3,000 psi is cheaper?
Exterior concrete in Michigan should hit 4,000 psi at 28 days. That mix is denser and carries the entrained air pockets that give freezing water somewhere to go instead of popping the surface. A 3,000 psi mix survives fine down south. Around Warren it starts pitting in 5 to 7 winters.
When can we actually park on the new driveway?
Walk on it after roughly 24 hours. Park a car or pickup after day 7. Keep anything heavy, an RV, a loaded delivery truck, a dumpster, off until day 28 when the slab reaches design strength. A car at day 3 might not crack anything that day, but the stress it plants tends to surface as cracks a season or two on.
What time of year is the pour scheduled?
Pour season in Michigan runs about May into October. The slab wants 7 straight days above 50 degrees to cure right. We can pour colder with blankets and accelerator admixtures, but it adds cost and those late slots go quickly. The easy route is a March or April walk through that locks in a May pour date.
Aftercare

What keeps a new driveway sound for decades

A cured driveway asks for little, and the little it asks for matters. The spring after its first winter, put down a penetrating siloxane sealer, then repeat every 2 to 3 years so road salt stays out of the surface. Keep an eye on the saw cut control joints. Cracking is supposed to happen there. A joint spreading past a quarter inch wants polyurethane caulk before water works underneath and freezes. Shovel by pushing, not chipping. A steel edge shaves the broom texture off and opens the door to spalling. And go easy on deicer the first two winters, since the slab is still gaining strength through that stretch.

  • Seal with a penetrating siloxane sealer in spring after the first winter, reseal every 2 to 3 years.
  • Fill any joint that opens past a quarter inch with a polyurethane joint caulk before the next freeze.
  • Push snow with a poly blade or rubber edge rather than a metal one, which scuffs the broom finish.
  • Hold off on rock salt and calcium chloride for the first two winters. The slab is still finishing its strength gain, and deicers hit hardest in that window.
  • Cracks belong at the saw cut joints. One that wanders off on its own points to a base or rebar problem, and that means a call back to whoever poured it.
Finished broom-finish concrete driveway leading to a brick home.
FAQ

Questions Warren homeowners ask about new driveways

How long does a concrete driveway last in Michigan?
Poured the right way, a concrete driveway here can last decades with light care. We build to current Michigan spec. That means a four inch slab, steel rebar through the middle, a strong 4,000 psi mix with tiny air bubbles for freeze resistance, and clean control joints cut into the top. The thinner mixes used back in the 1970s tend to flake by year 25. The best thing you can do to stretch the life of a slab is reseal it every two or three years.
Can concrete be poured in winter in Michigan?
We pour from about May through October. Concrete likes the heat. A fresh slab needs seven days above 50 degrees to cure to full strength, so the warm months are the safe window. Cold weather pours can be done with heated blankets and special mixes, but they cost more and the schedule fills fast. We start booking May work back in March, and we stop taking new spring jobs by the middle of September. If you call in October, we will most likely set you up for the next spring.
Is concrete or asphalt better for a Michigan driveway?
For most homes here, concrete is the better long run value. A well poured slab typically lasts decades, while asphalt usually gives you 15 to 20 years. Concrete also needs less upkeep, just a fresh seal every two or three years. And it holds up to the freeze and thaw cycles that crack a weak slab. Asphalt costs less up front and goes in fast, but it softens in summer heat and rolls into ruts where you park. If you plan to stay in the house past ten years, concrete is the smarter buy.
How much should a concrete driveway cost per square foot in Warren?
We do not quote a flat price per square foot from the curb, and you should be wary of any crew that does. The real number turns on the slab, the base under it, how much we have to tear out, and the apron at the street. So we come look at the driveway in person, free, and hand you a fixed written quote. That quote covers the demo, the base, the steel, the pour, and the finish. A bid made without a look tends to grow once the work starts.
How long until I can park on a new concrete driveway?
Walk on it day one. Wait a full week before you park a car or a pickup on it. Heavy loads like an RV or a packed truck should stay off for 28 days, which is when the slab finally reaches its full design strength. Driving on it early may not crack it that day, but it leaves stress in the concrete that shows up as cracks a season or two later. Most people park on the street the first week, then ease onto the new slab after day seven.
